Phase III header.jpg

Phase III

Construction KICKS OFF november 2020!

The final phase of One Nashville’s tenant-centered improvements is a tenant lounge, accessible from both building entrances, boasting a large conference room, abundant seating and new retail.



closing out the final phase…

march 2021

March was the last full month of construction in the lower level. The final phase of our 2-year improvement plan will be complete in mid-April when the temp wall comes down, furniture and artwork is delivered and installed, and we relocate our management team (for a final time) to their new home within the tenant lounge. We can’t wait to unveil our favorite phase of the project!

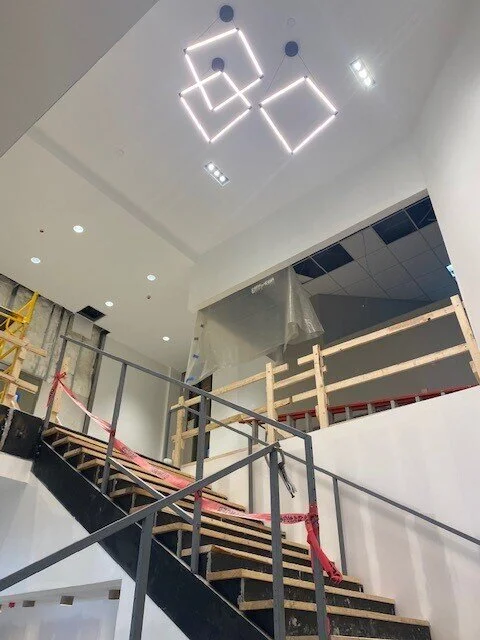

  • Lighting has been installed within the conference room, management office and the new stair

  • Fire-proofing and all HVAC/plumbing/electrical was completed

  • Concrete was polished and carpet has been installed

  • Ceiling grid was installed within the new conference room

  • Monumental staircase was framed, poured and is near completion

  • Storefront for the old management office (Suite 110), visible from the monumental stair, has been completed

  • TV’s have been installed within the conference room

that long-awaited monumental stairwell begins…

february 2021

  • Crash decking was installed in the earlier half of the month, and installing guard rails to begin cutting and removing concrete for the new stairwell

  • Ceiling inspections were completed and hard lid ceilings were installed

  • Teams began to prep the area to run electrical

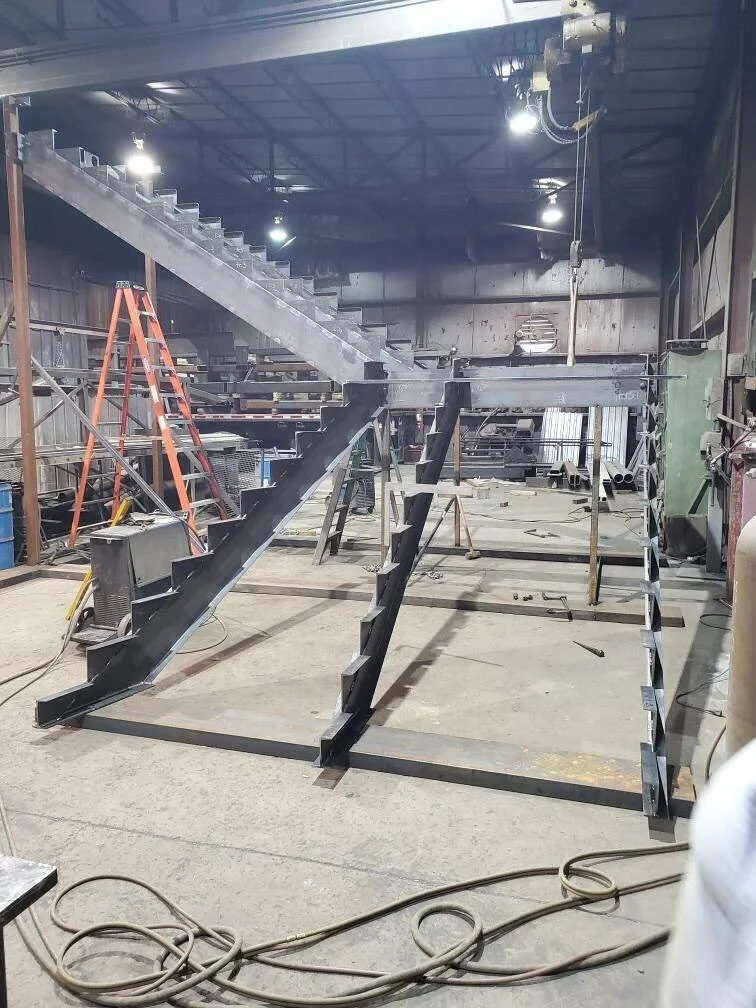

  • Concrete was removed and frame steels were installed for the new stairwell

  • Tilework in the tenant lounge bathrooms was started and completed






drywall and lighting and priming, oh my

january 2021

At just about halfway through the third phase, things are really starting to take shape.

  • Insulation and drywall has been completed - squaring off the conference room and new management office from the future tenant lounge

  • Ceiling light fixtures and all fire protection are almost complete

  • Priming, painting and hard ceiling installation will end the month and carry into February







phase iii is just getting started as the end of the year approaches

December 2020

Despite 2020 not being the year that everyone thought it was going to be, One Nashville kept things moving to make 2021 at the building, a place tenants will want to come back to.

  • Graphics on the lobby temp wall announce what tenants have to look forward to (and a reminder of where you can find the onsite management team!)

  • Wall framing continued, and drywall and insulation began to be installed.

  • New monument signage at the corner of 4th & Commerce compliments that new stair that was completed in Phase II nicely, don’t you think?




THE FINAL PHASE in one nashville’s phased renovation project KICKS OFF

NOVEMBER 2020

New signage is being installed around the property, closing out Phase II. One Nashville tenants have likely noticed that the current management office has been replaced with a temporary wall at the end of the elevator lobby. Something exciting is coming…

  • Demo of the ground floor has started, starting with floor abatement

  • Wall framing is underway

  • New temp wall has been placed at the end of the elevator lobby - you can now find your management team in Suite 1820!
